Q4 Peak Season Planning: Why Your Holiday Pet Toy Orders Need a 90-Day Lead Time

Overview: To guarantee Q4 delivery, your tech packs must be locked by July 15th for our pet toy contract manufacturing. A strict 90-day pet toy production lead time is non-negotiable for custom plush and rubber items to bypass peak-season raw material shortages and vessel booking delays.

Last year, a major European importer completely missed Black Friday because they failed to account for custom fabric dyeing times. They submitted their plush squeaker toy order in late August, assuming our standard daily output capacity could bypass the bottleneck. However, their custom Pantone required specific dyeing vat minimums, delaying raw materials by 25 days before a single piece of fabric reached our cutting floor. By the time their goods hit the port, vessels were fully booked, leaving their inventory stranded until mid-November.

As the Production Planning Manager at Wehao Pets, your reliable dog toy supplier, I monitor capacity bottlenecks on our factory floor daily. Our production lines operate on strict allocations, and Q4 requires an inflexible 90-day planning window. We enforce this because the safety stock of raw materials depletes rapidly across the Dongguan supply chain by September. For custom rubber or TPR items, machine setup calibration takes precise engineering, and custom mold creation lead time adds a minimum of 15-20 days before mass production can even begin.

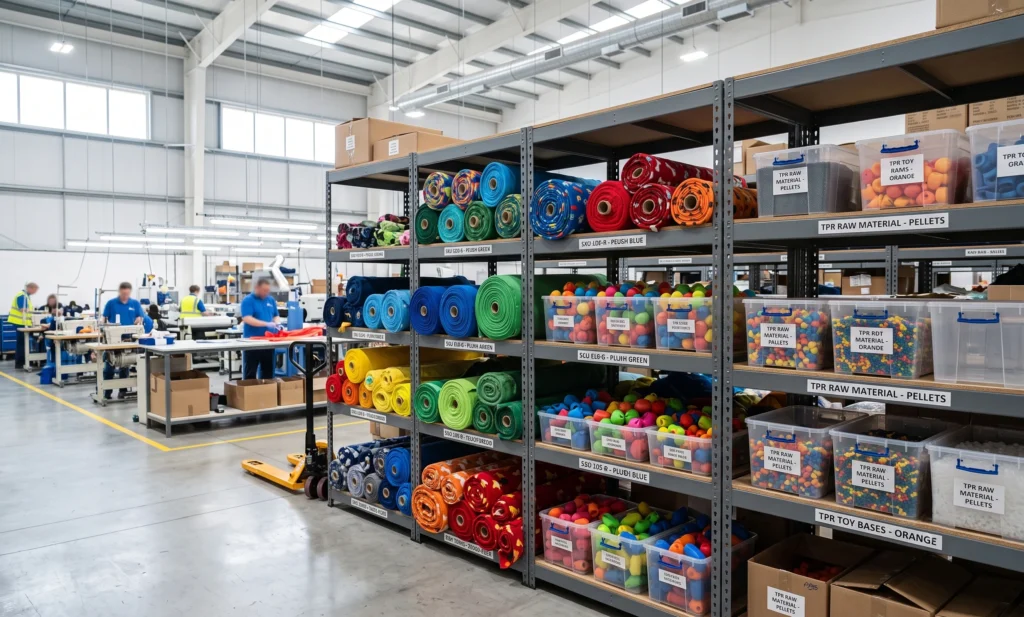

Stacks of custom dyed plush fabrics and raw materials staged for pet toy contract manufacturing on the cutting floor.

To understand exactly where your days are spent, we have mapped out our standard peak-season manufacturing schedule:

Production PhaseTime Required (in Days)Potential Bottlenecks
Raw Material Sourcing & Dyeing15-25 DaysDyeing vat minimums, custom fabric delays
Mold Creation & Machine Setup15-20 DaysMachine setup calibration, mold testing
Cutting & Stitching / Injection20-25 DaysDaily output capacity limits during peak season
Assembly, QC & Packing10-15 DaysRigorous safety standard compliance testing
Buffer & Port Staging5-10 DaysFreight forwarding delays, Golden Week holidays

If we are going to maintain our schedule and secure your inventory, our planning department requires total alignment from your purchasing team. We cannot start the clock on your production run until we have the following:

  • Approved Tech Pack & Bill of Materials (BOM): We cannot reserve factory floor space without finalized dimensions, materials, and Pantone codes.
  • ⚠️ Signed Pre-Production (PP) Sample Approval: Mass production is completely paralyzed until you physically receive and formally approve the golden sample.
  • ⚠️ Advance Deposit Clearance: Raw material sourcing (especially for custom fabrics and TPR) will not begin until the financial transfer clears our international accounts.

FAQs on Peak Season Production

Why is the pet toy production lead time longer in Q4?

During Q4, global demand maximizes our daily output capacity. Suppliers of raw materials (like squeakers and TPR) also face severe backlogs, extending our inbound supply timelines.

Can I expedite my pet toy contract manufacturing order if I pay a rush fee?

No. Machine setup calibration and mold creation lead times require fixed technical hours. Attempting to rush these processes compromises product integrity and safety compliance.

How do Chinese national holidays impact my reliable dog toy supplier deliveries?

National holidays, specifically the Golden Week in early October, halt all factory operations and port logistics for a minimum of 7 days, requiring buffer times to be built into all Q4 orders.

Secure Your Q4 Capacity

Do not wait until our factory floor is fully booked. Submit your tech pack now to secure your spot in our production schedule before capacity fills up. Visit our Contact Us page to initiate your order: https://wehaopets.com/contact-us/.
